Proving Constructive Acceleration in Construction Disputes

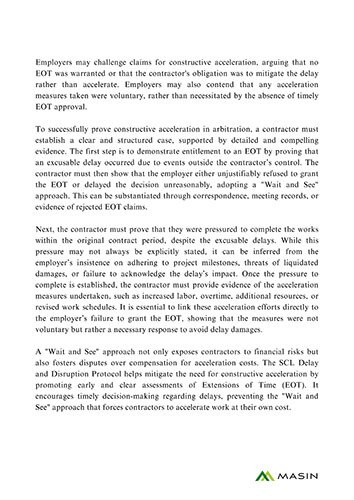

Constructive acceleration arises when a contractor is compelled to complete the works within the original contract period, despite the presence of excusable delays that would justify the granting of an Extension of Time (EOT). This typically occurs when the employer either delays the approval of the EOT or disputes its entitlement, leaving the contractor with no choice but to mitigate the risk of delay damages by accelerating the works at their own expense. A common cause of constructive acceleration is the employer’s “Wait and See” approach to EOT claims. Instead of awarding an EOT prospectively based on the predicted effects of a delay event, the employer delays its decision until the actual delay materializes. This deferral of the EOT decision forces the contractor to implement acceleration measures to meet the original completion date, effectively creating an implied instruction to accelerate the works.

When to Use ?

Prospective analysis is particularly useful during ongoing projects, especially for addressing straightforward delays or meeting contractually required forecasts.

Methods of Prospective Analysis

Frequently Asked Questions

Get answers to frequently asked questions about everything we do.

What is constructive acceleration in construction?

Constructive acceleration occurs when a contractor is forced to accelerate work to meet the original project schedule, despite being entitled to an Extension of Time (EOT) due to excusable delays. This typically happens because the employer delays or refuses to grant the EOT.
